Casey South Drainage Basin Improvements
Road Closure Anticipated Start and Completion Dates
- E. 57th Street and Battey Intersection: Early June to September 2025
- Battey Street from E. 57th St. to E. 58th Street: Mid-June to Mid-August 2025.
- E. 58th Street and Battey Intersection: Early August to Mid-August 2025.
- Anticipated time of completion for final paving and reopening of the roadways to all traffic: September 2025.
Brief Overview of Status Updates for Casey Improvements
Phase 2-2: November 2025 Updates
500 Block East 56th Street
- Installation of Storm pipe has started this week
600 Block East 56th Street
- The large interference manhole is complete in Paulsen.
- Continue watermain work through intersection.
- Replace curb inlets and curb/driveway aprons.
- Expected to Pave 600 block and Paulsen in January 2026
300 Block East 57th Street
- Paved and open to traffic
200 Block East 57th Street
- Watermain work is progressing. Expected to Pave in January 2026
Habersham Street
- Expected to Pave in January 2026
Battey Street & East 58thStreet Intersection
- Paved and open to traffic
Battey Street between East 57th and East 58thStreets
- Paved and open to traffic
Phase 2-2: Updates- July 2025
500 & 600 Blocks of East 54th Street:
- Open to traffic.
- Final close out items being performed (minor repairs to curbs, street, etc.).
600 Block East 56th Street:
- Stone and gravel being installed so residents can access driveways with their vehicles
- Anticipated to reach Paulsen & E. 56th St. by September 2025
300 Block East 57th Street:
- Roadway anticipated to be paved and open to traffic by September 2025
- Pressure tests are ongoing for new waterline system
200 Block East 57th Street:
- Improvements to begin early to mid-September 2025
Battey Street & East 58th Street:
- 54” pipe and new waterline systems being installed
- Roadway anticipated to be paved and reopened to traffic by September 2025
Battey Street between East 57th and East 58th Streets:
- Roadway anticipated to be closed to traffic until September 2025.
Phase 2-3B Habersham Village and Abercorn St. Improvements [MODELING COMPLETE]
2025: Detailed design to be completed of near surface storm pipe network upstream of proposed tunnel entrance. Modeling was completed in 2023 to determine pipe sizes for 100-year design storm conveyance.
For additional updates, contact Philip Kalogitonas, Capital Projects Liaison, at 912-351-3409.
Casey South Drainage Basin Improvements: Phase 2 – Public Meeting Presentation
- Full project completion for East 56th Street: Spring 2026.
Phase 2-3A Deep Tunnel [ASSESSMENT COMPLETE]
Late 2024: Procurement of final design expected for mile-long, 10-foot-diameter, 150-foot-deep tunnel beneath 61st Street from Habersham Village to Casey Canal. Tunnel feasibility assessment was completed in 2023.
54th St. between Reynolds and Atlantic Ave. [PROJECT COMPLETE]
2023: Installation of 60-inch-diameter storm pipe more than triples drainage capacity of previous storm line.

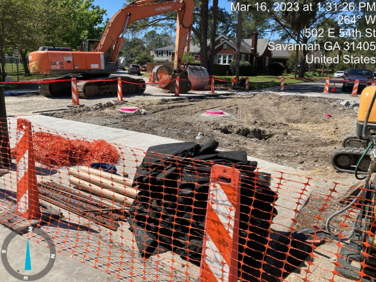

Recently completed construction on 54th St. between Reynolds and Atlantic.
Phase 2-1 and 2-2 Construction Kickoff [CONTRACT AWARDED]
March 2024: Construction to commence on 30-month project in 2 phases.
- Phase 2-1: Installation of 60-inch pipe beneath 54th St. between Atlantic and Harmon.
- Phases 2-2: Installation of 72-inch pipe beneath 56th and 57th streets between Abercorn and Harmon.
- November 2024: Construction to commence on the 600Blk of East 56th Street
